Detailed Estimates for Exterior Remodeling What to Expect

You've just opened two exterior remodeling bids for your Utah home, and the totals are far apart. One contractor offers a single price for “complete siding replacement.” The other lists removal, wall preparation, siding panels, trim, flashing, labor, disposal, and permit handling. Both estimates sound reasonable, but you can't tell whether the lower bid is less expensive or leaves important work unstated.

That's the problem detailed estimates solve. They turn a bottom-line number into a decision tool. For roofing, siding, and windows exposed to Utah's sun, snow, wind, freeze-thaw cycles, and changing weather, the material and installation assumptions matter as much as the total.

Introduction Why Detailed Estimates Matter for Utah Homes

A homeowner in Salt Lake City might compare a roof replacement bid with another homeowner's quote and assume the difference comes from contractor markup. Often, the explanation sits lower in the document. One estimate may include tear-off and disposal, while the other assumes the existing roof can remain. One may specify a particular shingle, underlayment, flashing method, and ventilation plan. The other may use broad language such as “install new roofing.”

Those descriptions aren't equivalent. A detailed estimate helps you ask whether both contractors are pricing the same roof, the same preparation, and the same finish. It also shows whether a price is fixed, provisional, or dependent on conditions that won't be visible until work begins.

Utah exterior remodeling has plenty of variables. A roof can reveal deteriorated decking after removal. Siding work may require repairs around windows, corners, or penetrations. Window replacement can involve trim, insulation, air sealing, interior finishing, and disposal. If those tasks don't appear in the scope, you need to know whether they're excluded, included elsewhere, or likely to become a change order.

The practical question isn't “Which bid is cheaper?” It's “What work does each bid actually purchase?”

A useful estimate should make the project understandable before you sign. You should be able to identify the surfaces being remodeled, the products being installed, the labor assumptions, the allowances, the exclusions, the schedule, the payment milestones, and the process for handling unexpected work.

This guide focuses on the audit that many estimate guides skip. You'll learn how to compare line items, spot allowance risk, test exclusions, evaluate contingency language, and anticipate estimate drift. The goal isn't to make you choose the highest bid. It's to help you compare apples to apples, plan a realistic budget, and enter the project with fewer unanswered questions.

What a Detailed Estimate Really Means

A lump-sum quote gives you one answer: the total price. A detailed estimate gives you the reasoning behind that answer.

Think about buying groceries. A receipt that only says “food, total price” doesn't help you check whether you received the right items, whether a premium product replaced a standard one, or why the bill changed. A proper receipt lists each product, quantity, and price. A construction estimate works the same way.

From one number to a usable scope

A vague exterior quote might say:

  • Replace siding
  • Install new windows
  • Complete roofing system

That language identifies a general objective, but it doesn't define the work. A detailed version separates the project into measurable components, such as surface preparation, demolition, materials, labor, finishing, cleanup, permits, and warranty coverage.

One of the most widely used construction cost databases contains over 92,000 line items, organized by CSI MasterFormat and divided into materials, labor, and equipment, as described by RSMeans' construction cost database. That granularity lets estimators build itemized projections rather than rely only on broad averages. For a homeowner, the benefit is visibility. You can see what drives the total and identify which assumptions deserve verification.

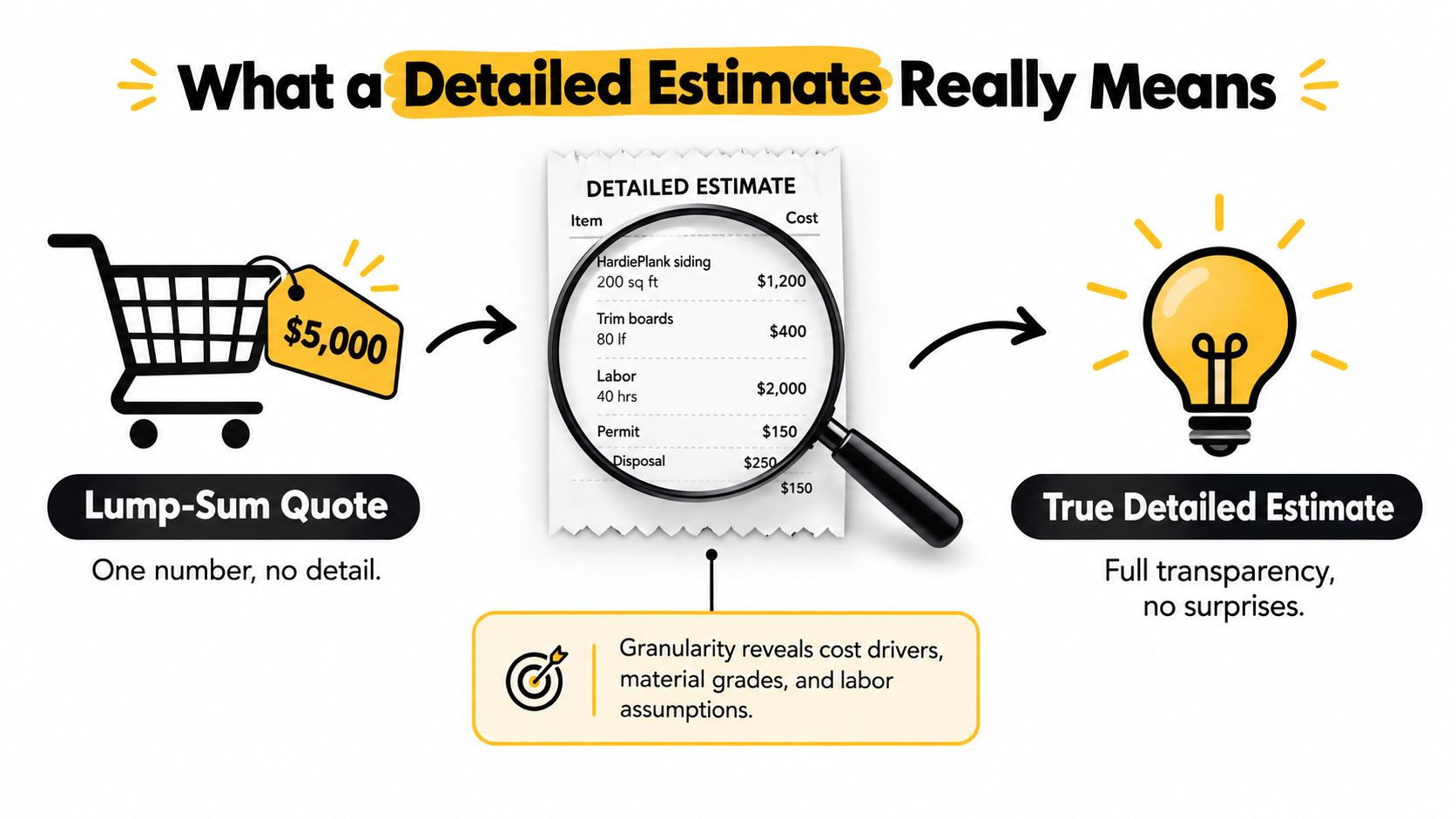

A diagram comparing a vague lump-sum quote to a transparent, detailed cost estimate for construction work.

A detailed estimate doesn't need to show every internal calculation or overwhelm you with technical language. It does need enough information for you to understand what is being measured, what is being supplied, and what could change.

Estimate, bid, and proposal aren't identical

An estimate is a calculated projection based on the known scope and assumptions. A bid is usually a contractor's priced offer to perform defined work. A proposal often combines the price with specifications, schedule information, payment terms, warranties, and contract conditions.

The labels matter less than the contents. A document called a “proposal” can still be too vague to compare, while a clearly itemized estimate may give you the information you need.

Accuracy also changes as the project becomes more defined. Industry guidance distinguishes estimate accuracy from contingency, with early conceptual estimates carrying much wider uncertainty bands than near-bid estimates. AACE-style ranges described by Blaze Estimating's contingency guidance extend from roughly -20% to +100% for very early conceptual estimates to about -3% to +20% for near-bid estimates. Those ranges aren't permission for a contractor to be careless. They show why a preliminary budget shouldn't be treated like a final contract price.

You have enough detail to make a sound comparison when the estimate identifies the work area, product specifications, quantities or measurement basis, labor, preparation, exclusions, allowances, permits, disposal, schedule assumptions, and change-order process.

Critical Components Every Detailed Estimate Should Include

A complete exterior remodeling estimate should let you trace the project from the existing surface to the finished result. If a major step is missing, the total may look attractive because the estimate hasn't priced the entire job.

Scope of work

The scope should identify which surfaces, elevations, openings, and tasks are included. For siding, that might include the main wall areas, gables, soffits, fascia, trim, flashing, and areas around windows. For roofing, it should describe tear-off, underlayment, edge metal, valleys, penetrations, flashing, ventilation, and cleanup.

Look for measurement terms and limits. “Replace siding” is weaker than a scope that identifies the siding system, trim areas, preparation, and installation locations. Ask how the contractor will handle areas that aren't visible during the initial inspection.

Materials and labor

Product specifications should name the product line or define the grade, profile, color, thickness, finish, and accessories. If you care about a particular window frame, roofing system, or fiber-cement siding profile, it should appear in writing rather than exist only in a sales conversation.

Labor should be identifiable as a fixed task price, measurable unit cost, or clearly explained installation allowance. You don't necessarily need an hourly breakdown for every crew member, but you should understand whether labor includes preparation, installation, sealing, finishing, and correction of ordinary installation issues.

Allowances

An allowance is a placeholder for a selection or condition that hasn't been finalized. Common examples include fixtures, tile, specialty trim, colors, or hardware. The estimate should state the allowance amount, what it covers, and how the final price changes if your selection costs more or less.

A low allowance can make a bid appear cheaper without reducing the eventual cost. Ask whether the allowance includes material only or material plus associated labor, delivery, tax, and installation accessories.

Exclusions, permits, and disposal

The exclusions section deserves as much attention as the included-work section. Independent contractor-quote guidance recommends checking what is included, what is excluded, which materials are allowances, who handles permits and disposal, and which site conditions can change the price, as explained in Prendos' guidance on construction estimate accuracy.

Permit handling, inspection coordination, debris removal, haul-away, daily cleanup, protection of landscaping, and final cleanup should each have a clear status. “Cleanup included” can mean anything from sweeping the driveway to removing all construction debris and returning the site to its prior condition.

Schedule, payments, warranties, and changes

A reliable estimate states the expected start window, work sequence, weather assumptions, and events that may delay completion. Payment terms should connect amounts to milestones rather than leave timing open-ended.

The warranty section should distinguish material warranties from workmanship warranties. It should also identify registration duties, exclusions, transferability, and who handles a service request.

Contingency protects against identified risk. Estimate accuracy describes uncertainty around the base estimate. They aren't the same line item.

Industry guidance places contingency separately from estimate accuracy and describes contingency as an allowance for identified risks. The referenced guidance notes that construction contingency often falls within 3% to 25%, depending on project definition and phase, while accuracy bands describe the expected uncertainty around the estimate itself. A homeowner should ask what risks the contingency addresses instead of treating it as a vague extra charge.

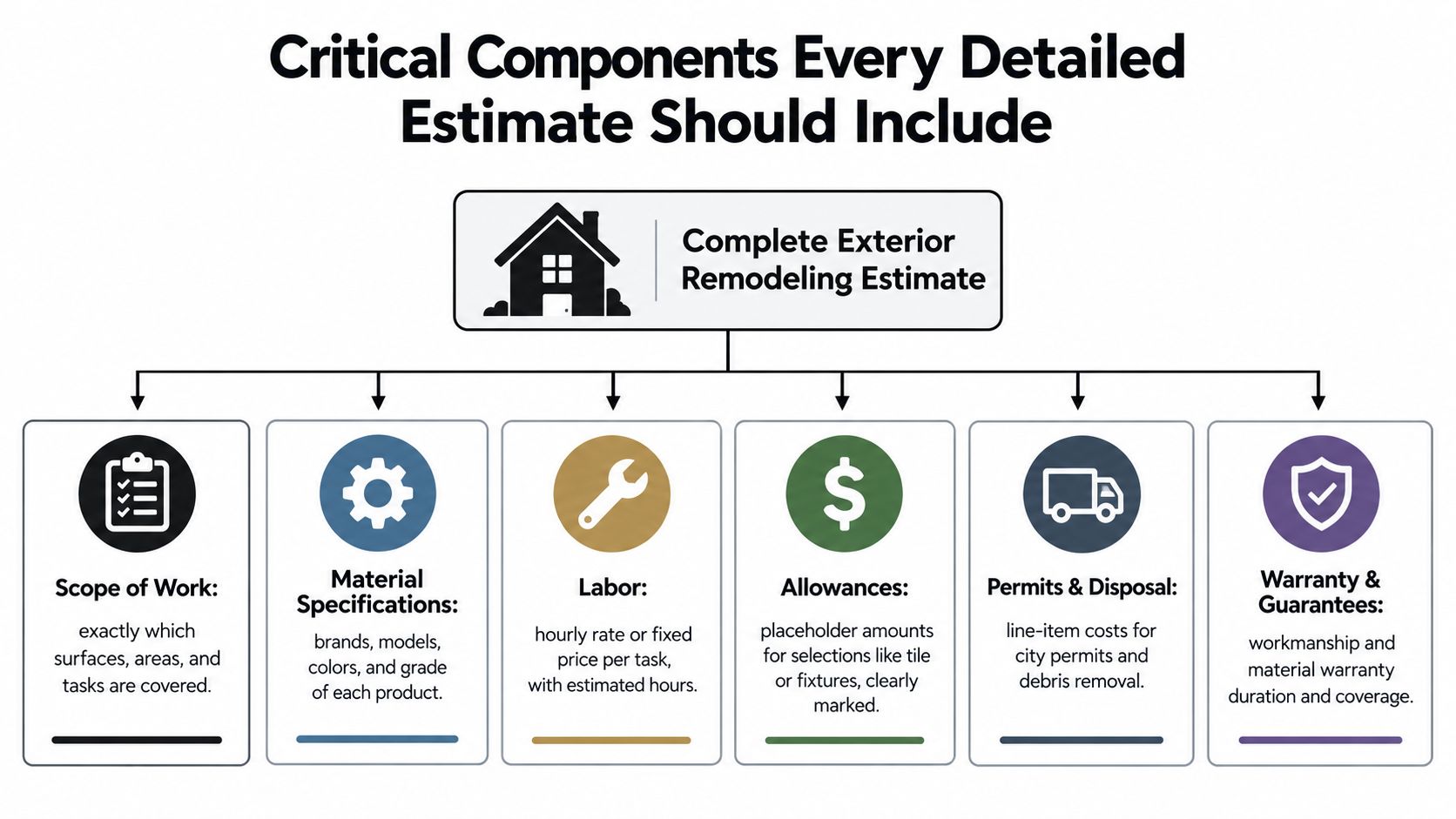

An infographic detailing the six essential components required for a complete exterior remodeling project estimate.

Example Line Item Breakdowns for Roofing Siding and Windows

A line-item breakdown becomes easier to understand when you compare it with the kind of wording homeowners often receive in a short quote. Consider three common Utah projects.

For a roof, a vague estimate might say “complete roof replacement.” A detailed estimate could separate existing-roof tear-off, debris loading, disposal, deck inspection, replacement decking if required, underlayment, ice and water protection where specified, shingles, starter and ridge products, flashing, ventilation, pipe boots, labor, and final cleanup. The estimate should also state how concealed damage will be priced if removal reveals conditions that couldn't be confirmed beforehand.

Siding requires similar care. The document may identify siding material, wall coverage, starter strips, corner posts, window and door trim, frieze or rake boards, flashing, housewrap or weather-resistive barrier work, insulation, caulking, fasteners, color selections, labor, and disposal. If you're comparing materials, an external resource such as TimberSol Ltd.’s guide to house cladding cost can help you understand why cladding prices vary by material and installation requirements. It shouldn't replace a site-specific estimate, but it can give you useful vocabulary for your contractor meeting.

Window estimates should identify each opening or window type, dimensions or measurement basis, frame material, glass package, color, installation method, flashing, insulation, air sealing, interior or exterior trim, screens, disposal, and finish work. A single “window replacement” line leaves too many of those decisions hidden.

Cost Element Vague Quote Shows Detailed Estimate Shows
Roof removal “Roof replacement” Tear-off method, layers assumed, loading, disposal, and cleanup
Roofing materials “New shingles” Product line, color, underlayment, flashing, ventilation, and accessories
Siding “Replace siding” Siding profile, coverage, trim, flashing, preparation, insulation, and finish
Windows “Install new windows” Unit type, glass package, opening, installation, air sealing, trim, and disposal
Labor “Installation included” Tasks covered, preparation, installation method, and finishing responsibilities
Unknown conditions Not addressed Inspection limits and written change-order procedure

The table isn't a pricing formula. It's an audit tool. If one contractor lists five cost elements and another lists one, compare the scope before comparing totals.

Homeowner Checklist and Questions to Ask Before You Sign

Take the estimate to the meeting as if you were checking a set of plans. Read every line and mark it included, excluded, allowance, or unclear. Don't let a verbal explanation remain verbal if it affects price, appearance, schedule, or warranty.

Check the scope first

Confirm the exact areas being remodeled. Ask whether the estimate includes all elevations, dormers, gables, soffits, fascia, trim, penetrations, window surrounds, and difficult-to-access sections. If the contractor inspected only visible surfaces, ask what happens when concealed conditions appear.

Use these questions:

  • What is included? Can you identify every demolition, preparation, installation, finishing, and cleanup task?
  • What is excluded? Which repairs, surfaces, permits, disposal tasks, or interior finishes aren't part of this price?
  • What conditions can change the price? Are concealed damage, structural repairs, code corrections, access restrictions, or owner-selected upgrades handled separately?

Separate allowances from fixed prices

Circle every allowance. Ask what product or service it represents, whether installation is included, and how the final price is calculated if your selection differs. A material allowance should never be mistaken for a guaranteed product price.

If the estimate uses phrases such as “as needed,” “standard materials,” or “repair where necessary,” request a definition. Those phrases may be reasonable for uncertain conditions, but the document should explain how the contractor measures and approves the added work.

Verify administration and protection

Ask who obtains permits, schedules inspections, protects landscaping, removes debris, and performs final cleanup. Confirm the payment schedule, estimate expiration date, insurance information, workmanship warranty, product warranty, and service process.

For exterior projects that change appearance, you can also ask for product samples, elevation drawings, or a visual planning aid. An AI deck design tool from OutdoorBrite may help homeowners explore exterior concepts, but the signed estimate still needs written product specifications and installation details.

Before signing, ask:

  1. How are change orders requested, priced, approved, and documented?
  2. Can work proceed without my written approval of an added cost?
  3. Which timeline assumptions depend on weather, inspections, or material delivery?
  4. What does the workmanship warranty cover, and who responds if a problem appears?
  5. Which selections must I finalize before ordering begins?

If any answer is unclear, ask the contractor to revise the estimate. A clean document protects you and the contractor because both parties can refer to the same scope.

Common Red Flags and Cost Drivers to Watch For

The lowest total can be the most expensive option if it leaves risk outside the document. A bid deserves careful review when it offers a single lump sum, uses unusually low allowances, omits exclusions, or says nothing about change orders.

A contractor may not know every concealed condition before demolition. That uncertainty is normal. The red flag is failing to explain how the uncertainty will be inspected, priced, approved, and documented.

Why buffers deserve scrutiny

Construction research has identified a gap between contingency and actual change exposure. One statistical analysis reported average contingency of 5.24% of award contract value compared with average contract variations of 9.92%, meaning the original buffer was smaller than the observed variation exposure in that analysis, as documented by Curtin University's construction contingency research.

The same source describes an Air Force construction contingency model that captured 44% of actual overruns, compared with 20% under current practice, and reduced average contingency budgeting error from 11.2% to 0.3%. Those findings don't predict what your home will cost. They do show why a line-item risk review is stronger than adding an unexplained cushion to a total.

Renovation work can carry especially high change-order exposure because existing conditions differ from drawings and visual assumptions. AIA contract research states that renovation and adaptive-reuse projects commonly experience change orders reaching 10% to 20% or more of contract value because of differing existing conditions, as explained in Volpe's change-order research.

Cost drivers specific to exterior work

Watch for these conditions:

  • Material grade: Premium roofing, siding, windows, trim, and hardware can change a line item substantially.
  • Roof geometry: Valleys, hips, dormers, penetrations, and steep or complex sections require more layout and labor.
  • Access: Tight yards, multiple stories, landscaping, and limited staging areas can affect handling and equipment needs.
  • Existing conditions: Damaged decking, sheathing, framing, flashing, or moisture-related repairs may appear after removal.
  • Weather and scheduling: Utah weather can affect sequencing, protection, drying, and installation windows.
  • Code and permit requirements: Required corrections or inspection items may affect scope if the original estimate didn't address them.

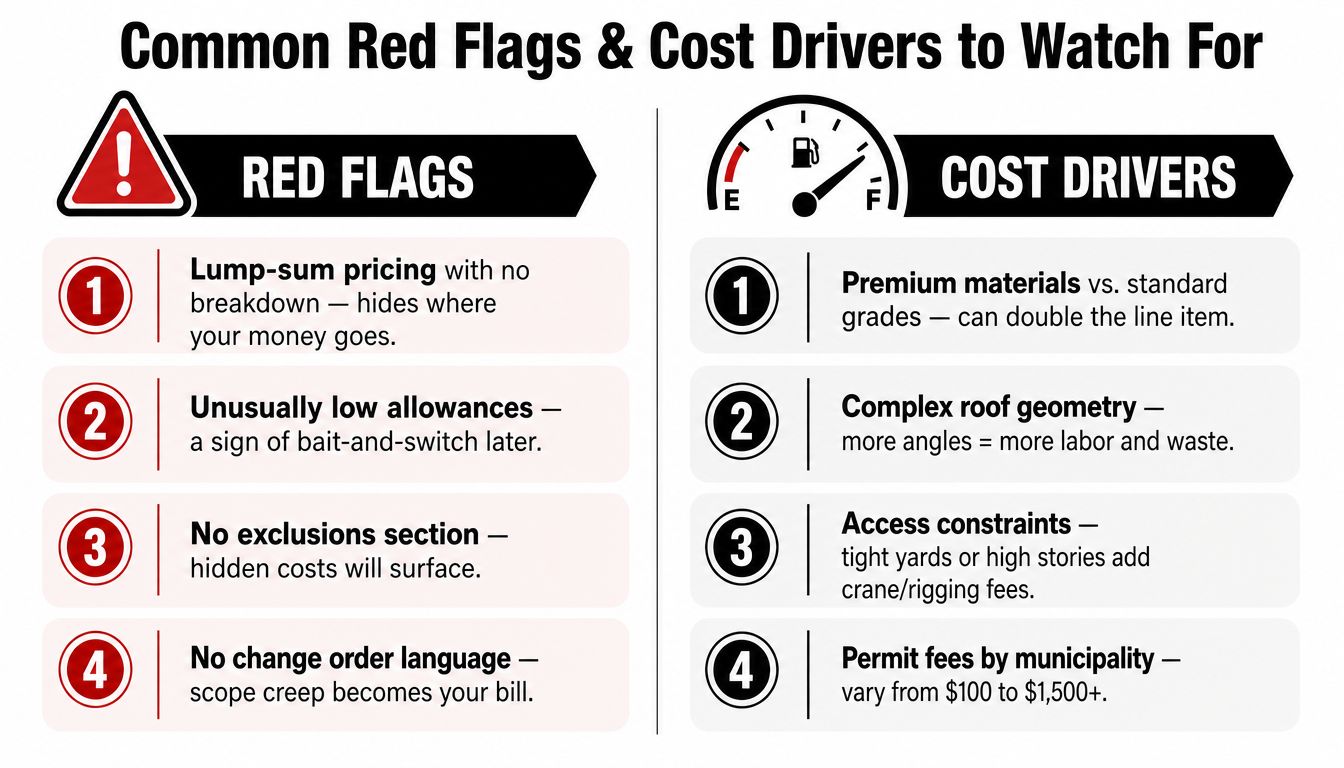

A list of red flags and cost drivers for construction projects shown in a comparison chart.

An estimate doesn't need to eliminate all uncertainty. It should make uncertainty visible before you commit.

Next Steps for Getting and Comparing Detailed Estimates in Utah

Start by giving each contractor the same project information. Share the same surfaces, desired products, color preferences, known repairs, energy goals, and schedule constraints. Ask each company to price the same scope instead of asking for a general “roof” or “siding” number.

Then normalize the documents. Put every allowance, exclusion, permit responsibility, disposal task, warranty, and change-order condition into a comparison sheet. If one bid includes window trim and another leaves it open, adjust your comparison before deciding which total is lower.

Review the contractor's Utah experience, licensing and insurance information, references, product certifications, and ability to explain local installation concerns. A detailed estimate is valuable only when the contractor can connect the written assumptions to the actual home.

Construction estimates should also be treated as revisable measurements. The U.S. Census Bureau describes construction spending estimates as monthly measures that are revised as more information becomes available. Its July 2026 national estimate reached a seasonally adjusted annual rate of $2,157.6 billion, compared with a revised $2,167.7 billion estimate for June 2026 and $2,242.6 billion for July 2025, as reported in the Census Bureau's construction spending data guide. Your remodeling estimate operates on a much smaller scale, but the principle is similar: a number is only as dependable as the scope and information behind it.

If electrical work is part of a broader exterior project, keep it separately defined and obtain a trade-specific document, such as requesting a free electrical quote from Black Rhino Electric. Before signing, use the checklist above and require written answers to every unclear item.

Superior Home Improvement describes a process built around detailed, upfront estimates, visible scope, itemized project components, clear timelines, and no-surprise pricing. Its Utah exterior remodeling services include energy-efficient windows and patio doors, roofing, siding, consultation, installation, and warranty documentation. Visit Superior Home Improvement to request a consultation and discuss an estimate that clearly separates included work, allowances, exclusions, and change-order procedures. Bring your comparison sheet so the conversation starts with the details that protect your budget.
