How Long Does Window Replacement Take

Most homeowners are physically without windows for only one to three days, but the full project from consultation to final inspection typically runs 4 to 10 weeks because ordering and scheduling take longer than the installation itself. For the work on site, professional benchmarks range from one day for 5 to 10 windows to two or three days for 20 or more windows or a multi-level home.

That difference explains why the question “how long does window replacement take” often gets an incomplete answer. The crew may finish the visible work quickly, while measurements, product selection, manufacturing, delivery, permits, and scheduling occupy much more of the calendar. A realistic plan separates those two timelines before you sign a contract.

The Two Clocks Every Homeowner Should Know

Window replacement follows two schedules, and they answer different questions. The installation clock measures crew time at your home. The project clock starts with consultation and ends after delivery, installation, cleanup, and inspection.

The on-site portion is often brief. Professional guidance places it at one day for 5 to 10 windows, one to two days for 10 to 15 windows, and two to three days for 20 or more windows or multi-level homes. Those ranges assume the crew can work through the openings as expected. Full-frame replacement, framing repairs, difficult access, or damage behind the trim can add time. Newman Windows outlines these installation ranges and the issues that commonly extend them.

The project clock includes the work homeowners rarely see: measuring each opening, confirming specifications, ordering, fabrication, delivery, permits where required, and fitting the job into the crew's schedule. HIRI reports an average 46.3 weeks end-to-end for a window and door project, with 13.9 weeks from decision to project start and 9.1 weeks to complete the work once it begins. Those figures describe a broader project cycle, not the crew's time at the house, so they should not be treated as a guaranteed window-replacement schedule. The Home Improvement Research Institute separates decision, start, and completion timing.

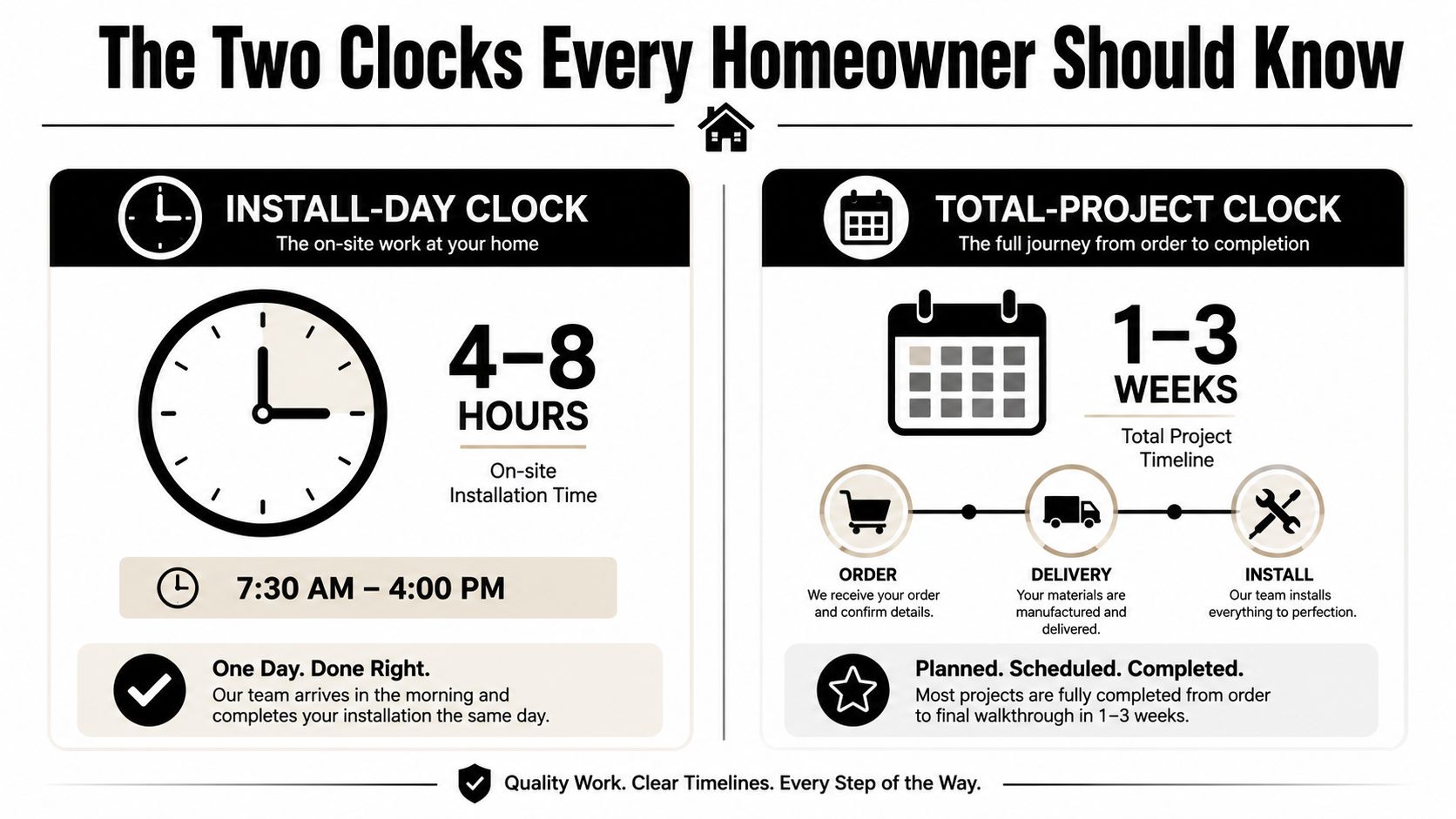

An infographic showing the two clocks for home improvement projects including on-site install time and total project timeline.

Practical rule: Ask for two dates, not one. Get the expected installation duration and the expected completion date from approval through the final walkthrough.

For a Utah homeowner planning an energy-efficient upgrade, the distinction affects planning. Comfort improves after the new units are installed and sealed, while product decisions, ordering, and crew availability are handled earlier. A quote that says “one day” may accurately describe labor while leaving the actual start date unresolved.

Before the Crew Shows Up

The installation crew may work for one day, while the project has been in motion for weeks. The calendar starts with the site visit. An estimator measures every opening, checks the existing frame and surrounding trim, and records the approved product requirements. That conversation may cover frame material, glass configuration, grid pattern, color, ventilation, and whether an insert or full-frame installation fits the condition of the opening.

A practical planning schedule looks like this:

Stage Typical Duration Notes
Consultation and measurements Qualitative, usually a scheduled in-home visit Every opening should be measured and checked for visible frame problems.
Quote preparation Qualitative, often several business days Multiple options, financing, and revisions can lengthen the response.
Product selection and approval Varies by homeowner and product Custom colors, specialty glass, and unusual shapes require more coordination.
Ordering and fabrication About 2 to 8 weeks, depending on the product Standard units generally move faster than custom or specialty units.
Delivery and final scheduling About 1 to 2 weeks after arrival in many projects The contractor confirms crew availability, access, permits, and any required approvals.

Planning guidance commonly places the overall project at 4 to 8 weeks, or about 6 to 10 weeks when ordering, fabrication, and scheduling are included. That range covers the period before installation, not just the time installers spend inside the home. Newman Windows provides the broader project range and identifies custom units and hidden damage as common causes of delay.

What controls the lead time

The product specification can matter more than the window count. A standard replacement unit may follow an established production path. A custom shape, unusual color, specialty glass package, or opening requiring nonstandard trim needs more fabrication and review. Hidden frame damage found during measuring or preparation can also change the scope, because the contractor may need different materials or additional repair work.

Delivery is not the same as installation. The contractor still has to confirm that the units match the approved order, coordinate labor, check access restrictions, and handle permits or approvals where required. Ask whether the quoted date is a target installation date or an estimated delivery date. Those dates serve different purposes.

Keep unrelated glass work outside the replacement scope. If you plan to add privacy film to glass that is staying in place, use a dedicated guide on how to apply window film. Separating the work clarifies responsibility for bubbles, edges, cleaning, and warranty coverage, and prevents a small finishing task from complicating the installation schedule.

What Happens on Installation Day

A well-run installation day starts with a scope check. The crew typically arrives in the morning, walks the home with the homeowner, confirms which openings are included, and identifies any access restrictions. Before removal begins, installers protect floors, furniture, countertops, and nearby finishes with drop cloths and temporary coverings.

The work then moves opening by opening. Installers remove the old sash or unit, inspect the exposed area, and check whether the existing frame or rough opening matches the approved installation method. They set the new window, use shims to establish level and square, fasten the frame through the jamb or designated attachment points, and adjust the operating sashes before sealing.

Sealing isn't a cosmetic step. Installers use appropriate insulation and perimeter sealing methods, including low-expansion foam where specified, backer rod where needed, and exterior caulking at exposed joints. Interior casing, drywall repair, or other trim work usually follows each opening rather than waiting until every window has been installed.

A practical benchmark places professional crews at 10 to 16 standard replacement windows in an 8-hour workday, with standard windows often taking 30 to 60 minutes each. Precision Door and Window explains how crew size, window count, and site conditions affect the daily pace. That range describes standard work, not a promise for every home.

Two professional contractors in blue uniforms installing a new white double-hung window while a customer watches.

The final walkthrough

At the end, the lead installer should demonstrate operation, locks, screens, and any ventilation features. Walk each opening before signing off. Look at the interior trim, exterior sealant, sill condition, glass cleanliness, and latch alignment. Ask which items are complete and which items, if any, require a return visit.

The crew also has to protect new glass during delivery and staging. Contractors and homeowners handling replacement units can review practices for secure glass transit packaging, especially when units must move through tight hallways or remain temporarily on site.

Insert Replacement vs Full Frame Replacement

The installation method is one of the strongest predictors of labor time. An insert, or pocket, replacement fits a new window into the existing frame. A full-frame replacement removes the old unit and frame down to the rough opening, exposing more of the wall assembly and creating a larger scope.

Insert work is usually faster because the existing trim, siding interface, and frame remain in place. Verified guidance places insertion work at about 30 to 60 minutes per window. A separate installation benchmark describes a pocket or insert replacement at about one hour per window, while a full-frame replacement may take 4 to 6 hours per window when the crew must remove and rebuild more of the opening. Pella describes the difference between pocket and full-frame installation.

Factor Insert / Pocket Replacement Full-Frame Replacement
Existing frame Remains in place if it's sound Removed to the rough opening
Trim and siding Usually less disturbed More likely to require removal and reinstallation
Labor intensity Lower for standard openings Higher because the opening is inspected and rebuilt
Best fit Sound frames with compatible dimensions Rot, damage, leakage, or a need to change the opening
Schedule effect Faster per opening Longer per opening and more dependent on concealed conditions

The faster method isn't automatically the correct method. An insert can preserve a damaged or poorly flashed frame, leaving the underlying problem in place. Full-frame work creates more disruption, but it lets the installer inspect the rough opening, address hidden deterioration, install new flashing and insulation, and rebuild trim where necessary.

The choice also affects the finished result. Inserts may preserve more of the existing interior and exterior appearance, while full-frame work can provide greater flexibility for changing the window size or exposing more glass. Ask the contractor to explain what remains behind the new unit, not just how quickly the crew can install it.

If you're adding connected security equipment after the replacement, review the practical door and window sensor benefits explained before selecting sensor locations. Sensors need a stable mounting surface and clear operation around the new frame.

What Can Stretch a One Day Job Into Several

A one-day installation estimate depends on several conditions lining up: the opening is sound, the correct products have arrived, access is clear, and the approved scope does not change. The crew can work quickly only when those conditions are confirmed before and during removal.

Hidden damage causes some of the biggest schedule changes. Rot at a sill or jamb may stay concealed until the old window is removed. Water intrusion can also reach insulation, sheathing, trim, or the rough opening, turning a replacement into repair work. Newman Windows lists hidden frame damage, wood rot, difficult trim reinstallation, and specialty units among the common causes of overruns.

The variables crews can't price perfectly from a distance

  • Rot and moisture damage: Deteriorated material may need removal, followed by replacement of sound blocking, drying, and sill reconstruction before the new unit is installed.
  • Structural changes: An oversized, shifted, or out-of-square opening can require reframing instead of routine shimming.
  • Code-related work: Safety glass, egress requirements, flashing details, and other code items may expand the work once the opening is exposed.
  • Height and access: Upper-level windows require added material handling, staging, and fall protection compared with ground-floor openings.
  • Specialty shapes: Arches, circles, bays, and other nonstandard units require precise shimming, support, and perimeter sealing.
  • Weather exposure: Rain, high wind, or freezing conditions can stop exterior sealing or make an exposed opening unsafe to leave unfinished.
  • Crew capacity: Crew size affects pace, but extra installers do not remove the time needed for protection, access, trim, or inspection.

Set expectations around a base schedule and a contingency plan. Ask what happens if the crew finds rot, an out-of-square opening, or damaged sheathing after removal. That answer is more useful than a promise that every opening will take the same amount of time.

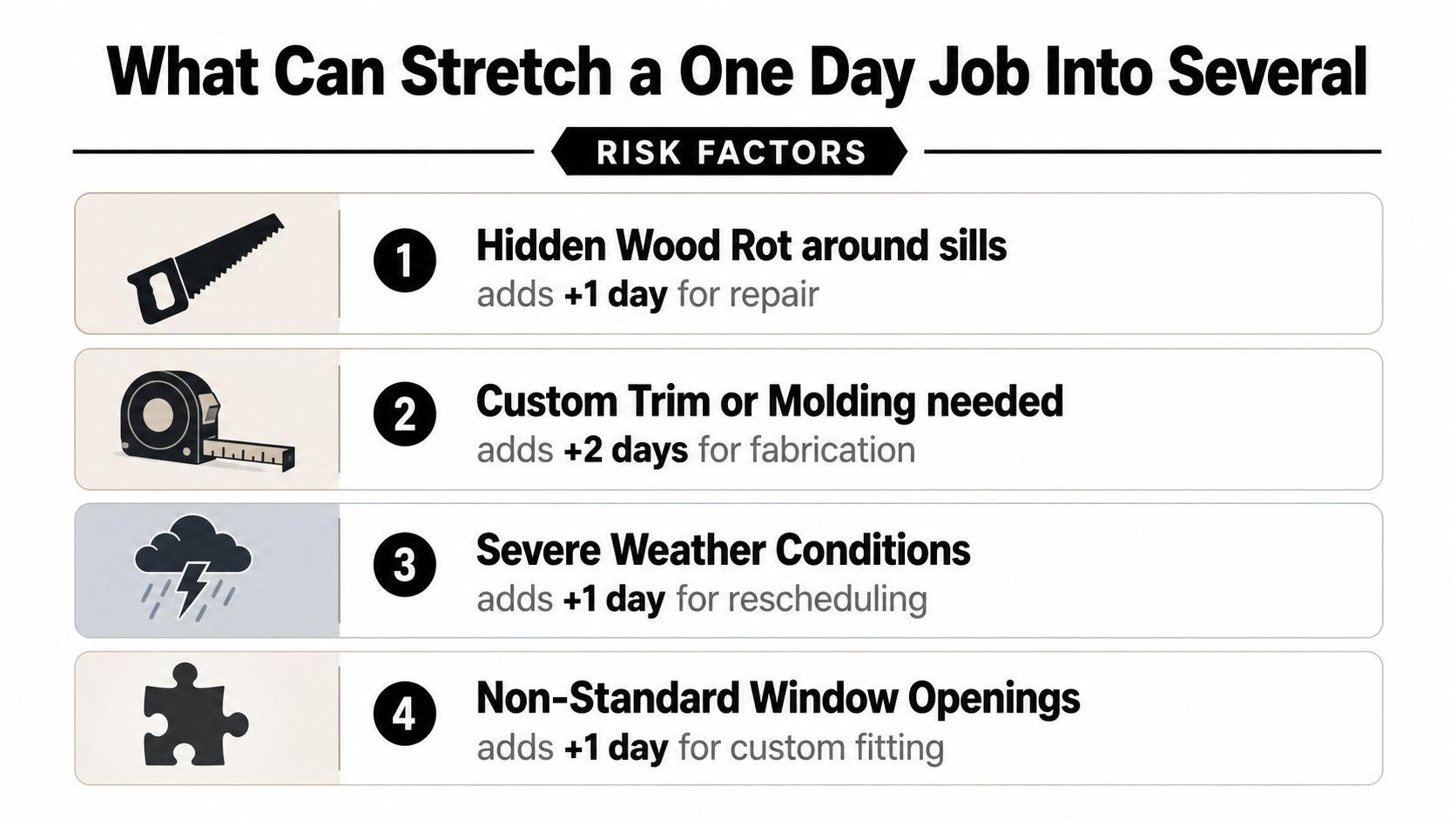

A list detailing four common risk factors that can cause window replacement projects to take longer than one day.

How to Prepare Your Home and Speed Things Up

Preparation removes small delays that accumulate across a full house. The day before installation, clear a three-foot path to every affected window, inside and outside. Remove curtains, blinds, rods, and wall décor, then move furniture and fragile items away from the work zone.

Use this checklist:

  • Clear access: Keep floors, stairs, and walkways open so installers can carry frames and glass safely.
  • Remove coverings: Take down blinds, curtains, screens, and security sensors unless the contractor has agreed to handle them.
  • Protect valuables: Relocate artwork, electronics, plants, and breakables away from dust and vibration.
  • Prepare the exterior: Trim shrubs and move planters, hoses, grills, and patio items away from the openings.
  • Confirm utilities: Make sure installers can reach electrical outlets and identify any areas where heating or cooling may be interrupted.
  • Secure pets: Place animals in a closed room away from the crew, open doors, and construction debris.
  • Plan for exposure: Arrange temporary climate control if an opening may remain exposed during extended repair work.
  • Reserve parking: Keep a clear place for the installation vehicle and materials.

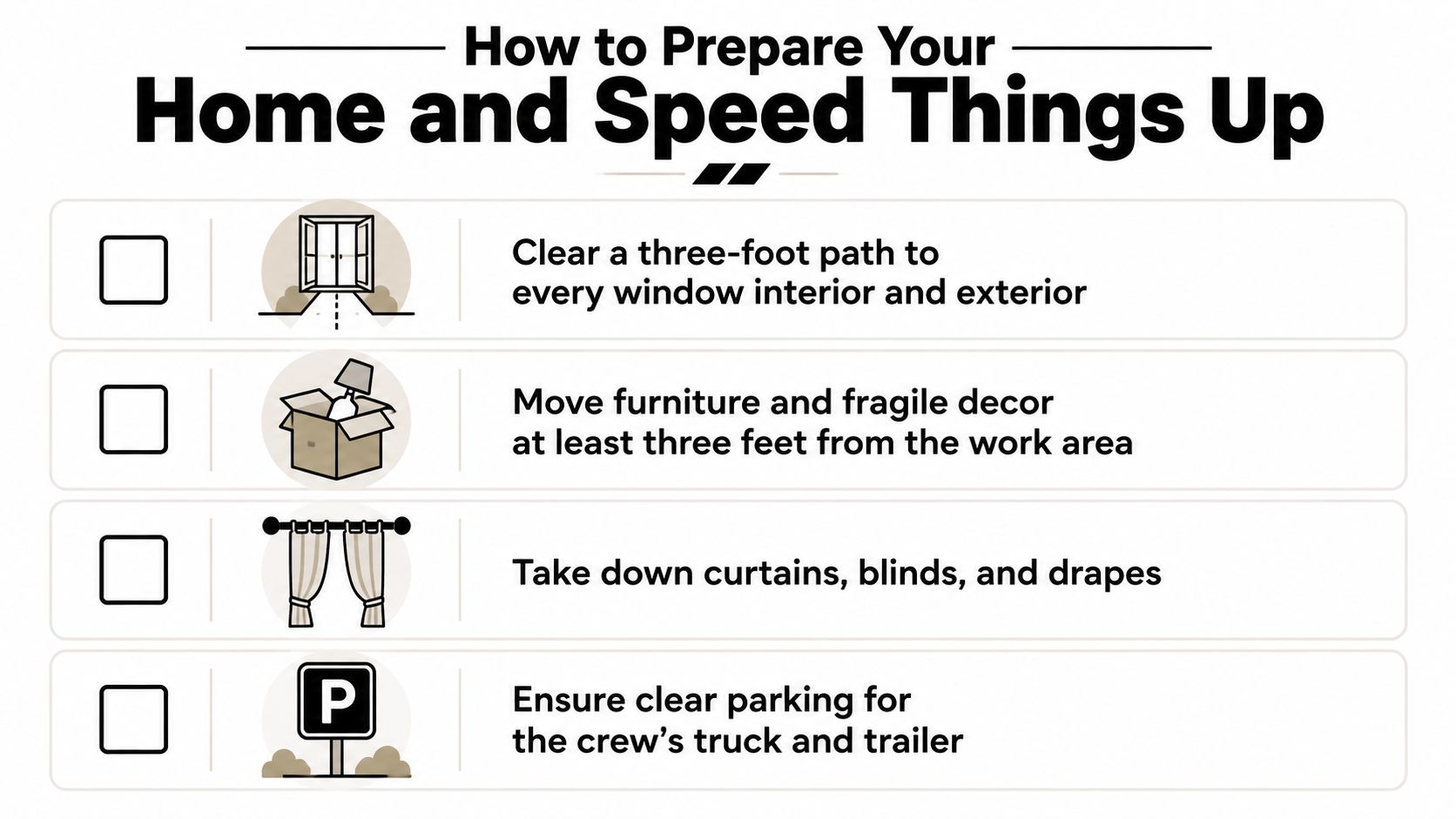

A checklist for homeowners detailing steps to prepare their property for a window replacement project.

On the morning of installation, confirm the arrival window, payment schedule, walkthrough process, and the person authorized to approve changes. Ask who will sign off on sealants, trim, and any repair work discovered after removal.

A prepared home helps the crew maintain its planned sequence. Don't assume preparation can reduce every project by a fixed amount, because the benefit depends on access and site conditions. It does, however, prevent avoidable interruptions that slow the work.

Planning a Realistic Timeline

A reliable window project plan separates two clocks. The on-site installation commonly takes one to three days, but the full schedule includes consultation, measuring, ordering, fabrication, delivery, trim work, and inspection. From the first planning steps to completion, the calendar often runs 4 to 8 weeks, or about 6 to 10 weeks when manufacturing and scheduling are included. The verified project guidance distinguishes hands-on work from the longer ordering and coordination period.

The schedule usually slips at specific handoffs. Incorrect measurements can delay ordering. Custom products may require more fabrication time. Removal can also expose rot, water intrusion, or framing problems, changing insert replacement into full-frame repair. Those conditions matter more than promising that every home will be finished in one day.

The job is complete only after each unit is installed, sealed, adjusted, and checked, with trim and caulking finished and debris removed. Confirming who can approve discovered repairs helps prevent a work stoppage during removal.
